SMRT to be fined S$3 million over maintenance and system lapses in 2024 East-West Line disruption
SMRT faces a S$3 million fine after a six-day MRT disruption in September 2024. LTA found the train involved had missed a scheduled overhaul, while TSIB cited weak response protocols to warning systems. The incident affected nine stations, impacting 500,000 daily journeys and requiring extensive repairs.

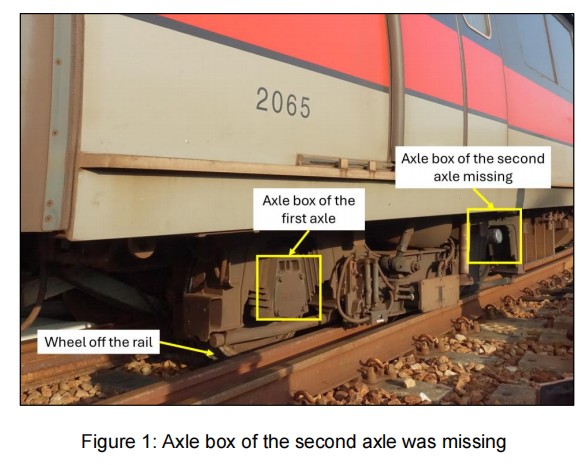

SMRT will be fined S$3 million following a six-day disruption on the East-West Line in September 2024. The Land Transport Authority (LTA) announced the penalty on 3 June 2025, citing serious lapses in maintenance practices and system response. On 25 September 2024, a key component known as an axle box dropped from a train travelling between Dover and Clementi MRT stations. This dislodgement caused the bogie—an undercarriage structure with wheels—to come off the rail, damaging the tracks and forcing a major service disruption. Nine stations between Boon Lay and Queenstown were affected, with normal service only resuming six days later on 1 October 2024. About 500,000 of the 2.8 million daily journeys were disrupted each day.
Ageing fleet and delayed replacement
The train involved was part of SMRT’s first-generation KHI fleet, in operation since the late 1980s. These trains were due to be replaced by newer Movia models, with full handover originally scheduled by March 2024. However, due to delays from the COVID-19 pandemic, the first Movia train was only delivered in May 2023, over a year behind schedule. As a result, SMRT continued to operate some older trains, including the one involved in the incident. LTA found that the failed train had not undergone a scheduled overhaul despite being overdue. While overhauls are required every 500,000km, SMRT extended this interval twice—first to 575,000km in August 2022, then to 750,000km in August 2024. At the time of the incident, the train had clocked 690,000km since its last overhaul in 2018. By then, only 18 of the 66 KHI trains had been overhauled. The train involved was not among them. SMRT extended these intervals based on internal analyses and fleet performance data. However, LTA said no detailed engineering risk assessment was carried out regarding the axle box overhaul interval.
Axle box damage and root cause analysis

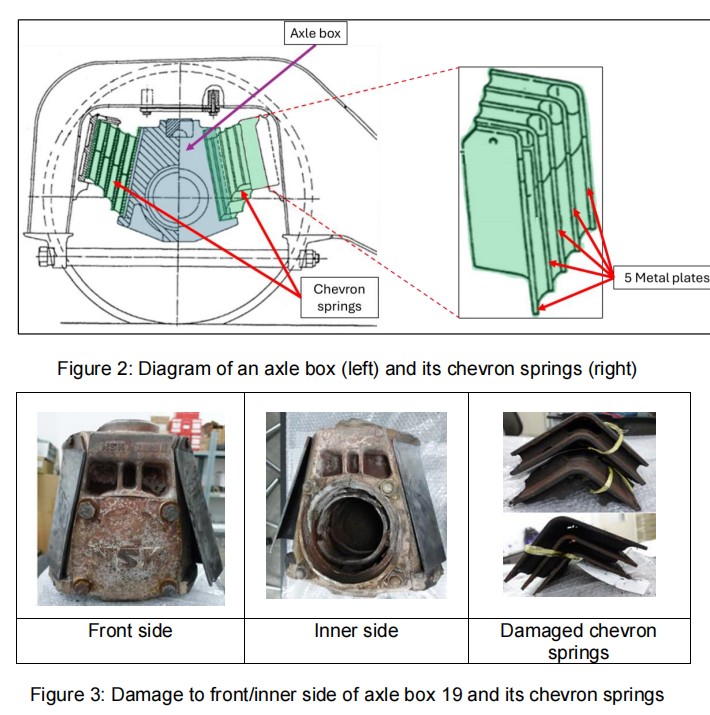

Investigators could not determine the precise cause of the axle box failure as the components were too severely burnt and damaged. These included the axle box itself, axle bearings, and chevron springs—critical parts within the bogie assembly. Nonetheless, LTA concluded that the likely cause was degraded grease inside the axle box. Grease degradation increases friction, which in turn accelerates wear and tear on components, potentially causing overheating.
