LTA's report of MRT network reliability: How reliable is it?

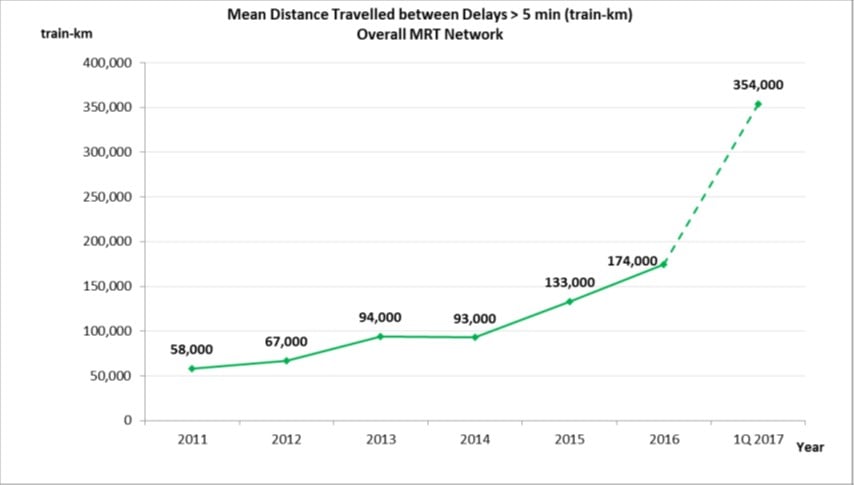

According to the Land Transport Authority's Rail Report, the Mass Rapid Transit (MRT) trains traveled further in first quarter of 2017 before encountering short delays, on track with the reliability target. “The reliability of the MRT network improved significantly in the first quarter of 2017, with the Mean Kilometre Between Failure (MKBF), measuring delays of more than 5 minutes, for the overall MRT network more than doubling from 174,000 train-km in 2016 to 354,000 train-km in 1Q2017.” “This improvement follows the steady progress of our major infrastructure renewal projects, as well as the operators’ investments in improving maintenance procedures and incident recovery processes,” LTA said.

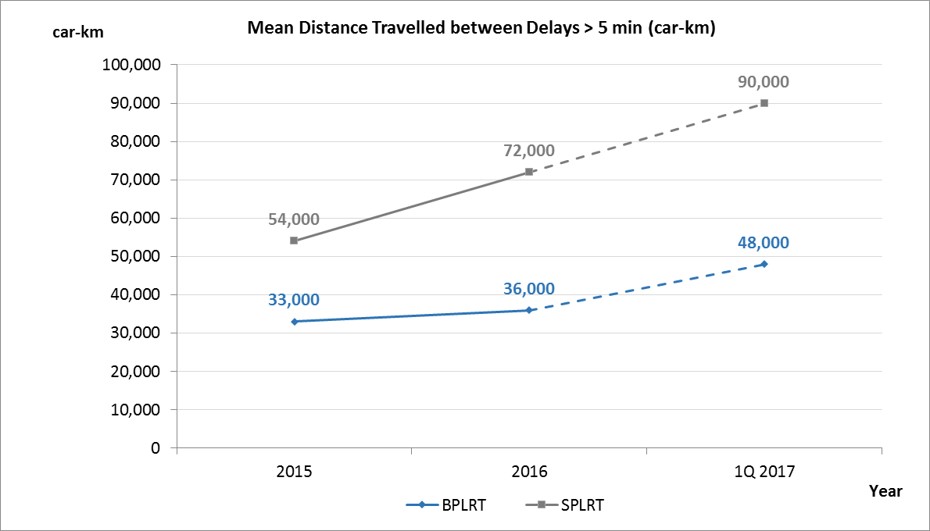

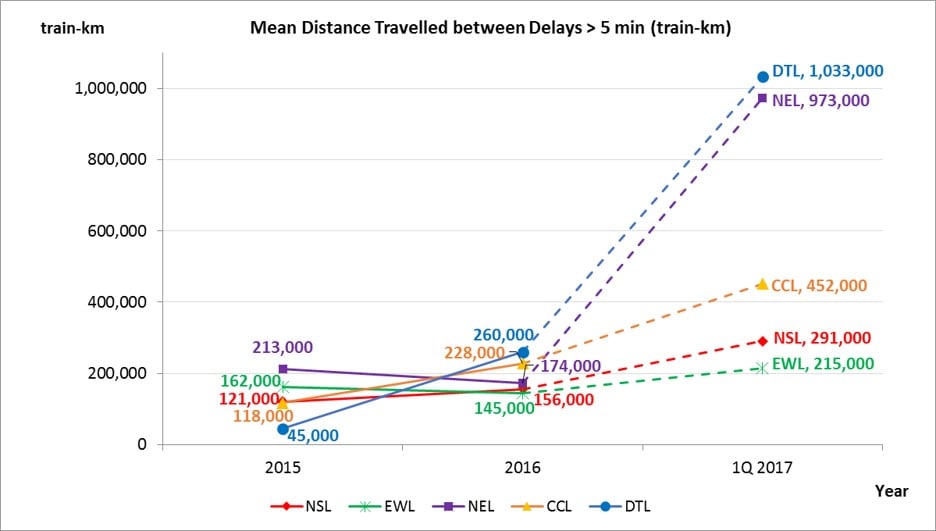

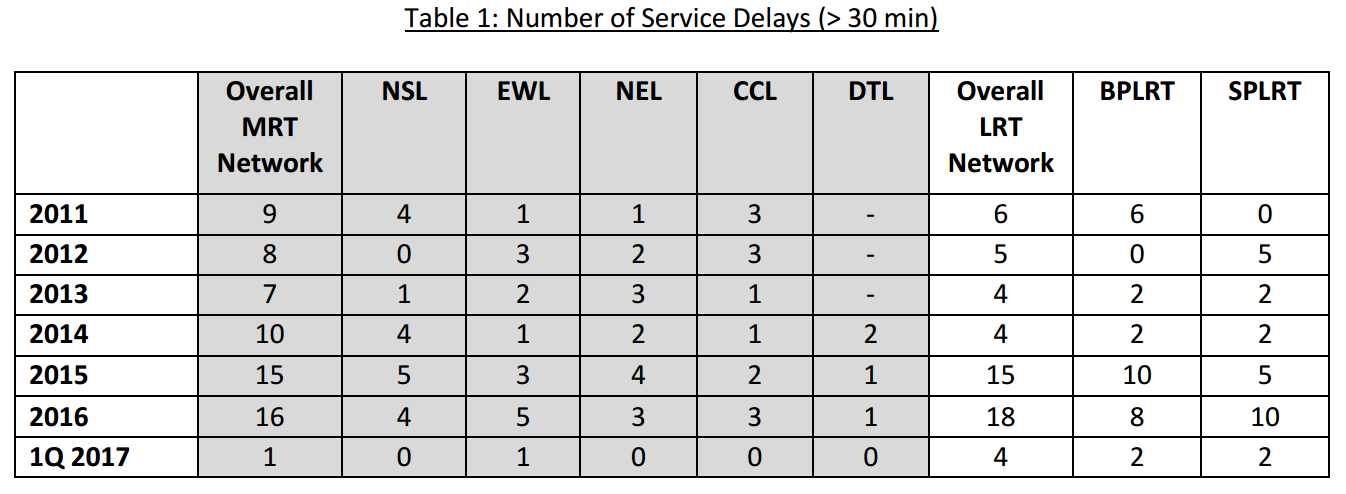

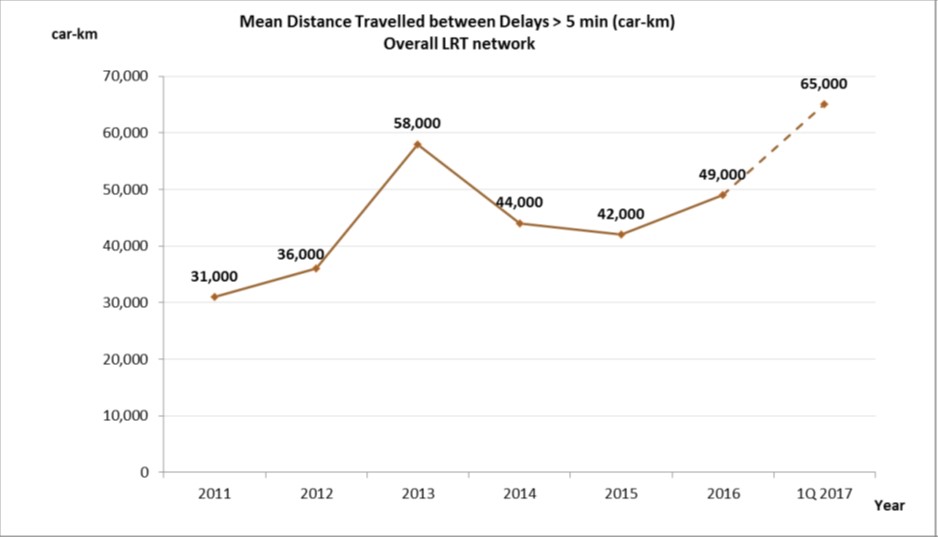

However, if one were to take a look at the chart produced by Failrail.sg, one can see that the number indicated by LTA doesn't match the figures that are being recorded. The site records occurrences based on media reports and social media posting by the transportation companies.

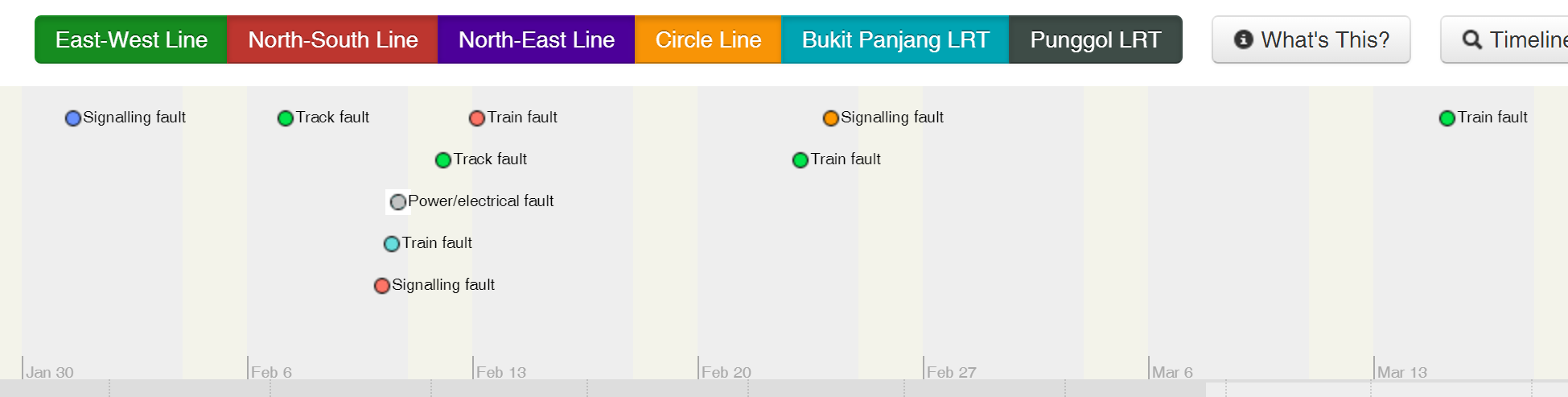

From time to time, TOC reports breakdowns that are not reported by the transport operators themselves. One such example was on 26 April where a delay occurred along East-West Line (EWL) without an official announcement from SMRT. Given that there are probably more breakdowns that go unreported, it is possibly that what Failrail.sg record is lesser than what actually take place. Furthermore, as what Leong Sze Hian stated his opinion earlier in a write up, "With the opening of more stations, addition of new trains, etc – isn’t it arguably, kind of like 'a no-brainer' to improve the 'distance travelled before breakdown' statistics?". Ultimately, the "improvement" in performance might be attributed to the increase of trains and stations rather than the reliability of the network in actual performance. LTA's statement of significant improvement in rail reliability is of no reassurance to commuters who are inconvenienced by the rail companies' lacklustre standards.
